Government infrastructure logistics

Tweed Shire Council
Headquarters & Depot Relocation

End-to-end project management, heavy transport, crane operations and site coordination for the complete relocation of a live council operation into its newly constructed facility.

ClientTweed Shire CouncilSectorGovernment & councilsDelivery modelDirect engagement
160Approximate transport movements
2,300 tApproximate operational assets relocated
22Foley Logistics personnel deployed
2 weeksActual delivery against a four-week program
ZeroReportable incidents and asset damage
The project requirement

A complete operational relocation—not a collection of truck bookings.

Tweed Shire Council approached Foley Logistics directly after the scale and complexity of the relocation had placed it beyond the practical capability of other transport providers that had considered the work. The Council needed one company capable of controlling the planning, specialist fleet, lifting, safety and site interface as a single operation.

Foley Logistics was engaged to coordinate the relocation of the Council’s headquarters and operational depot from a flood-prone facility to a newly constructed site approximately nine kilometres away. The scope covered heavy engineering equipment, workshop machinery, fleet-maintenance infrastructure, hazardous and flammable materials, operational stores, specialised equipment and office facilities.

Before mobilisation, Foley personnel attended both sites on multiple staggered planning and investigation days throughout the preceding month. Those visits were used to inspect assets and loads, confirm access, identify lifting and dangerous-goods requirements, develop the movement sequence and ensure Council operations could remain active throughout the transition.

Original programFour weeks
Actual deliveryTwo weeks
Pre-planningStaggered site investigations
ContinuityMaintained throughout
ResponsibilityPlanning through completion
Safety outcomeZero reportable incidents

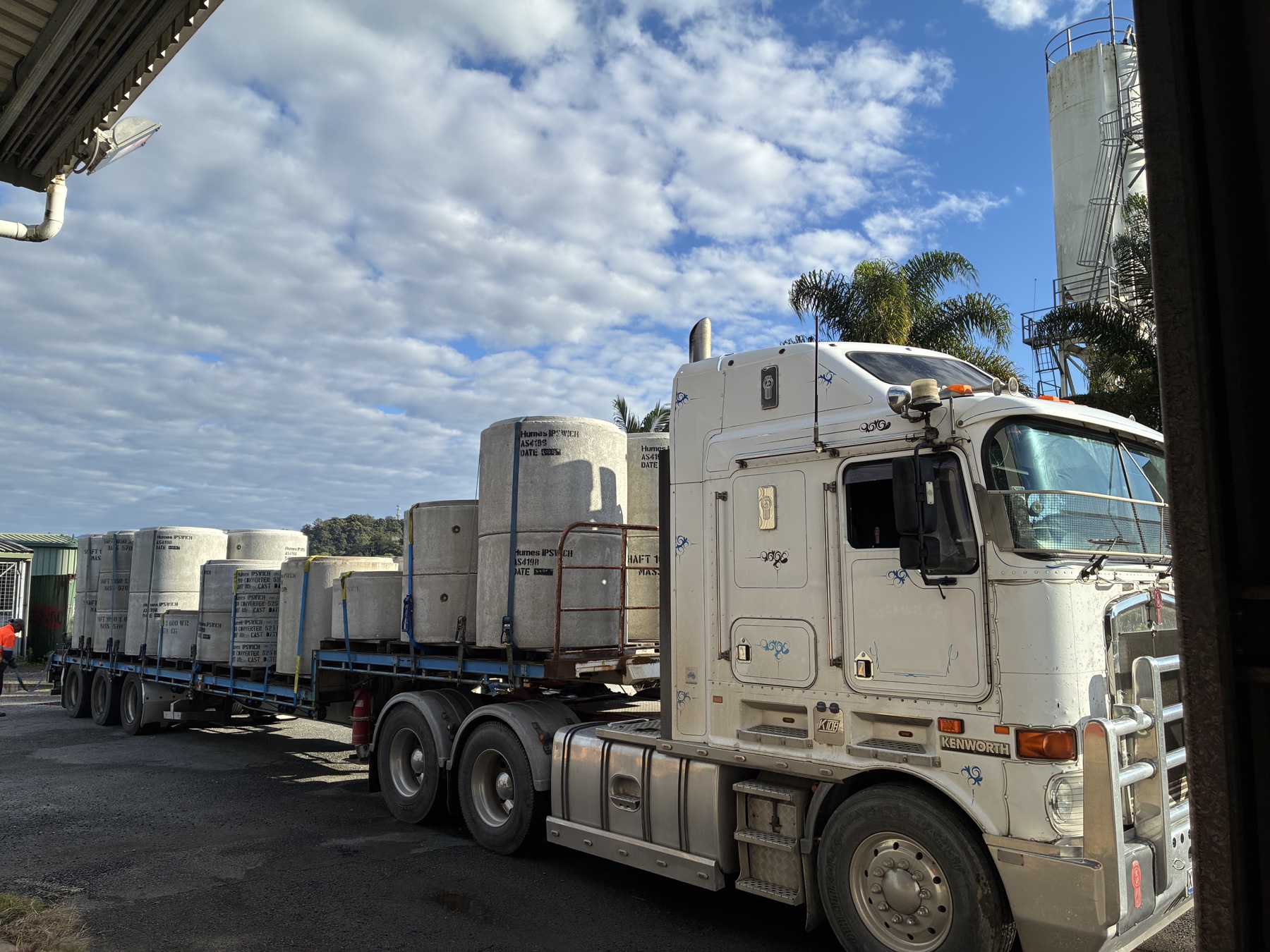

Prime mover transporting heavy council equipment during the Tweed Shire relocation

Heavy operational equipment prepared for a planned transport stage during the council relocation.
The operating challenge

Keep a public operation functioning while every major asset changes location.

The move combined heavy lifting, high-risk freight, numerous vehicle types and multiple workstreams across two active sites.

01 · CONTINUITY

Uninterrupted council operations

The relocation sequence had to protect critical services, minimise downtime and keep operational teams functioning.

02 · HEAVY ASSETS

Machinery and workshop infrastructure

Industrial lathes exceeding three tonnes, fleet-maintenance equipment and engineering machinery required specialist handling.

03 · HIGH-RISK FREIGHT

Hazardous and flammable goods

Controlled procedures, load inspections, suitable equipment and compliant movement planning were required.

04 · COORDINATION

Approximately 160 movements

Vehicle flow, site access, loading areas, crews and traffic controls had to operate through one daily program.

05 · PROTECTION

A newly constructed destination

Access routes, workshop areas and new infrastructure had to be protected during wet-weather and heavy-equipment activity.

06 · DEADLINE

A fixed four-week program

The project required disciplined sequencing, scalable resources and fast resolution of changing site conditions.

STAGE 01 · MONTH PRIOR

Investigate, inspect and define the scope

Foley’s project team completed multiple staggered site visits during the month before delivery. Assets, dimensions, load weights, access routes, destination readiness, lifting points, dangerous goods and operating constraints were investigated before the first vehicle was mobilised.

STAGE 02

Engineer the movement program

Fleet, lifting resources, traffic-control zones and daily work stages were sequenced around operational priorities and Council requirements. The plan gave each movement a defined vehicle, crew, handling method and site pathway.

STAGE 03

Mobilise the project team

A dedicated structure connected project management, operations, safety, crane-lift inspection, load inspection, qualified operators, licensed dangerous-goods drivers, riggers, dogmen, labourers and traffic-control personnel.

STAGE 04

Execute staged transport and lifting

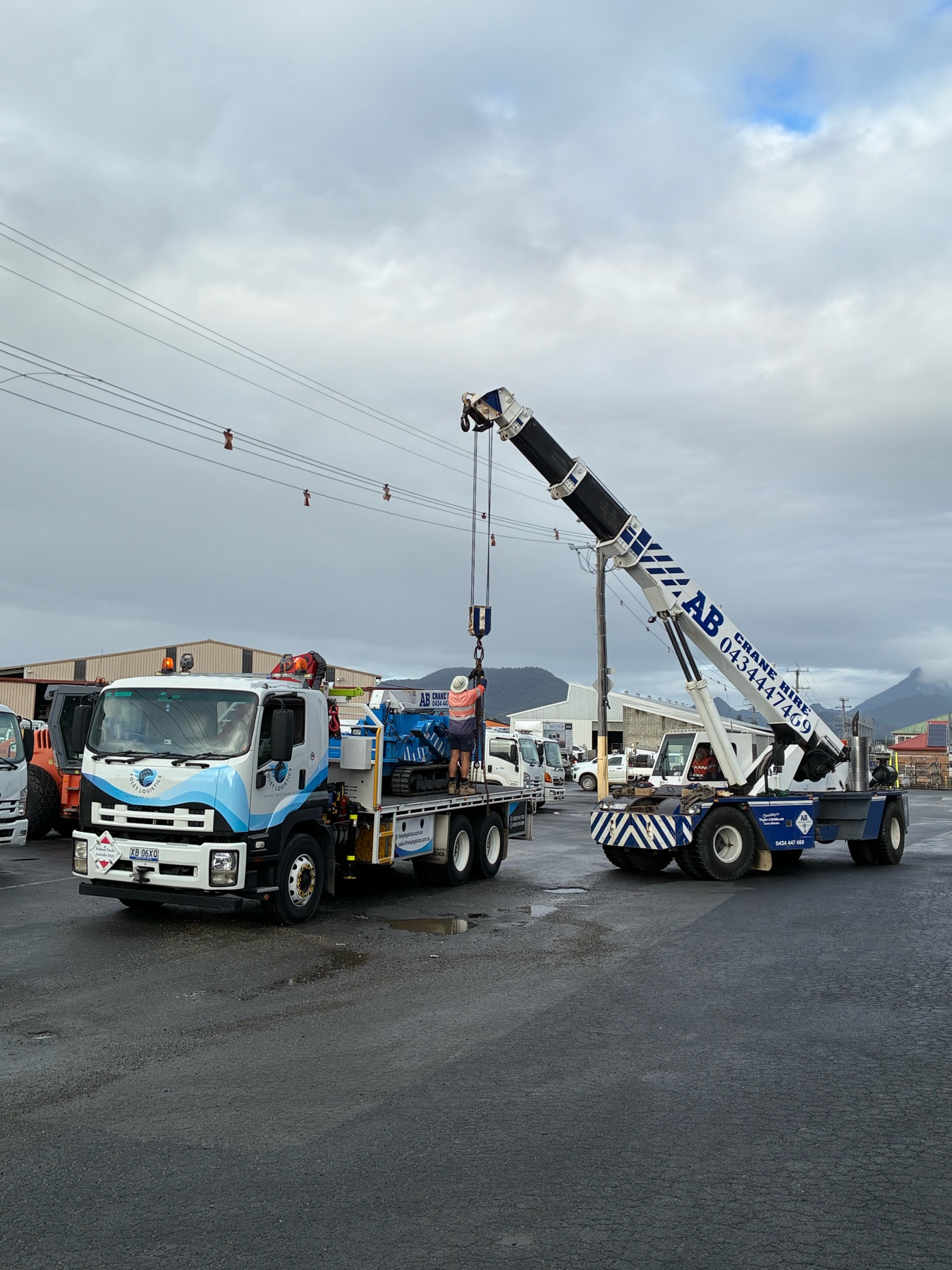

Crane trucks, prime movers, trailers, Pantechs, forklifts, courier vehicles, a spider crane and a 60-tonne mobile crane were deployed as required.

  • Heavy engineering machinery
  • Workshop tools and equipment
  • Warehouse inventory
  • Gas cylinders and dangerous goods
  • Office furniture
  • Operational stores
STAGE 05

Inspect every load and control site movement

Every load was checked before transport. Crane-lift inspectors reviewed lifting activity, dedicated traffic controllers directed vehicle and pedestrian movements, and dangerous-goods-licensed personnel managed gases and other controlled freight. Daily pre-starts were supported by SWMS, JSA, lift plans, radio communications and NHVR-compliant restraint.

STAGE 06

Close out ahead of program

The relocation was completed in two weeks—half the original program—with operational continuity maintained, zero asset damage and zero reportable safety incidents.

Capability deployed

Multidisciplinary control across transport, lifting and site execution.

PM

Project management

One accountable project lead coordinated scope, program, stakeholders, escalation and daily operational decisions.

FL

Multi-fleet allocation

Crane trucks, prime movers, Pantechs, semi-trailers, enclosed trailers, couriers and specialist combinations were matched to each stage.

CR

Crane and lift inspection

Qualified crane operators, lift inspectors, dogmen and riggers controlled lift planning, heavy machinery movements and final placement.

TC

Dedicated traffic control

Traffic controllers directed vehicle entry, loading zones, pedestrian separation and movement between the two operational facilities.

DG

Licensed dangerous-goods transport

Licensed personnel and defined procedures supported the compliant transport of gases, flammable products and other controlled materials.

✓

Every load inspected

Loads were inspected before movement for suitability, restraint, stability, route and task-specific handling requirements.

HSE

Safety and compliance

Site safety oversight, SWMS, JSA, lift plans, pre-starts and NHVR-aligned restraint were built into execution.

24

Daily coordination

Operational meetings, site supervision, radio communications and stakeholder updates maintained alignment throughout the move.

Project outcome

Delivered in half the planned time—and trusted with ongoing Council work.

The outcome demonstrates Foley Logistics’ ability to lead significant government relocations involving specialised transport, heavy lifting and multidisciplinary site coordination. Successful delivery established Foley Logistics as a trusted transport and logistics provider for further Tweed Shire Council requirements.

50% ahead of programTwo-week completion against the original four-week relocation schedule.
Operational continuityCouncil functions were maintained through the transition.
Zero asset damageHeavy, specialised and general operational assets arrived safely.
Ongoing confidenceProven planning and execution created a trusted basis for continuing Council work.
Project resources

A team structured around the operation.

LeadershipProject manager, operations manager and council liaison.
SafetySite safety officer, load inspector and traffic-management personnel.
LiftingQualified crane operators, dogmen, riggers and forklift operators.
TransportHeavy-vehicle, prime-mover, Pantech, courier and general-freight drivers.
Site executionLabourers, spotters and handling support across both facilities.
Specialist fleetSpider crane, 60-tonne mobile crane and task-specific equipment.
Environmental controlClean access routes, wet-weather controls and responsible waste handling.
Close-outCompletion verification, outstanding-item control and final handover.
